How to Switch from DOP to DOTP in a Production Line

The first calender batch off a fresh DOTP changeover usually tells you whether the team did the cleanout right. If a chalky film shows up on the chrome roll inside the first hour, that is plate-out from residual DOP fighting the new stearate balance — not a DOTP quality issue, and not something a higher mixer setpoint will fix.

I have walked enough of these DOP-to-DOTP changeovers to say it plainly: the switch hinges on what happens before the first DOTP pellet enters the mixer, on three numeric decisions in the formulation card, and on a Shore A reading at minute thirty of the transition batch. The phr math is the smallest part of the job.

Prepare the Production Line Before the Switch

The work that prevents a bad transition batch happens before any DOTP touches the mixer. Two prep tasks that line teams routinely skip — incoming-lot verification and a lubricant-package re-read — account for most of the first-batch failures I see.

Verify the Incoming Lot’s COA Against What You Qualified

Before adding to the mixer, ensure the incoming DOTP COA matches the lot you qualified your formulation against. Ester content and acid value drive the gelation behavior on your line; a lot one acid-value point off can shift fusion time enough to spoil a transition batch even when the phr is correct.

Verify ester content, acid value, water content, and color on every lot. Stage at least one full transition batch worth of material from a single lot so the changeover doesn’t double as a lot-variation experiment. Source DOTP that matches your qualified spec and condition it per the DOTP handling and storage guidelines before the first run.

Pull the Formulation Card and Review the Lubricant Package

The second prep task is the lubricant package, not the plasticizer. DOTP gels marginally slower than DOP because terephthalate has lower polarity than the ortho-phthalate, and that delay interacts with whatever calcium stearate / stearic acid / PE wax balance was tuned for DOP.

Calcium stearate counterintuitively decreases fusion time while boosting fusion factor, so a small bump in calcium stearate is the practical compensator for DOTP’s slower gelation — not a setpoint increase. Pull the formulation card, list every lubricant by phr, and tag adjustments for the first DOTP batch — same discipline if this is line-side execution of a broader DEHP phase-out where each grade changes over on its own schedule.

Engineer reviewing PVC formulation card before switch from DOP to DOTP plasticizer

Clean the Line to Switch Plasticizers Without Plate-Out

Visual cleanliness is not clean enough. Residual DOP in the high-shear mixer, the transfer pipework, and the ribbon blender migrates into the first DOTP batches and shifts hardness, plate-out behavior, and color. The acceptance criterion is not “clean to the eye” — it is a dump-sample Shore A reading within ±2 points of a pure-DOTP control sample run on a fully cleaned reference unit.

The purge sequence I run on a flexible PVC line: drain the DOP feed, wipe the mixer bowl and ribbon blender of free liquid, and run two purge cycles using virgin DOTP (or a sacrificial transition compound at half the production batch size). Pull a dump sample after each purge, mold a Shore A plaque, and read it after 24 hours.

If the reading is within ±2 points of the DOTP control, the line is at the migration-relevant residual threshold. If not, run a third purge. The same residue-removal logic applies to drum and IBC handling — the IBC cleanout procedure for DOP covers the upstream side of this.

If you see this defect, check: a chalky film on the calender chrome inside the first hour means the purge fell short. Pull the batch, re-purge, and re-test before continuing.

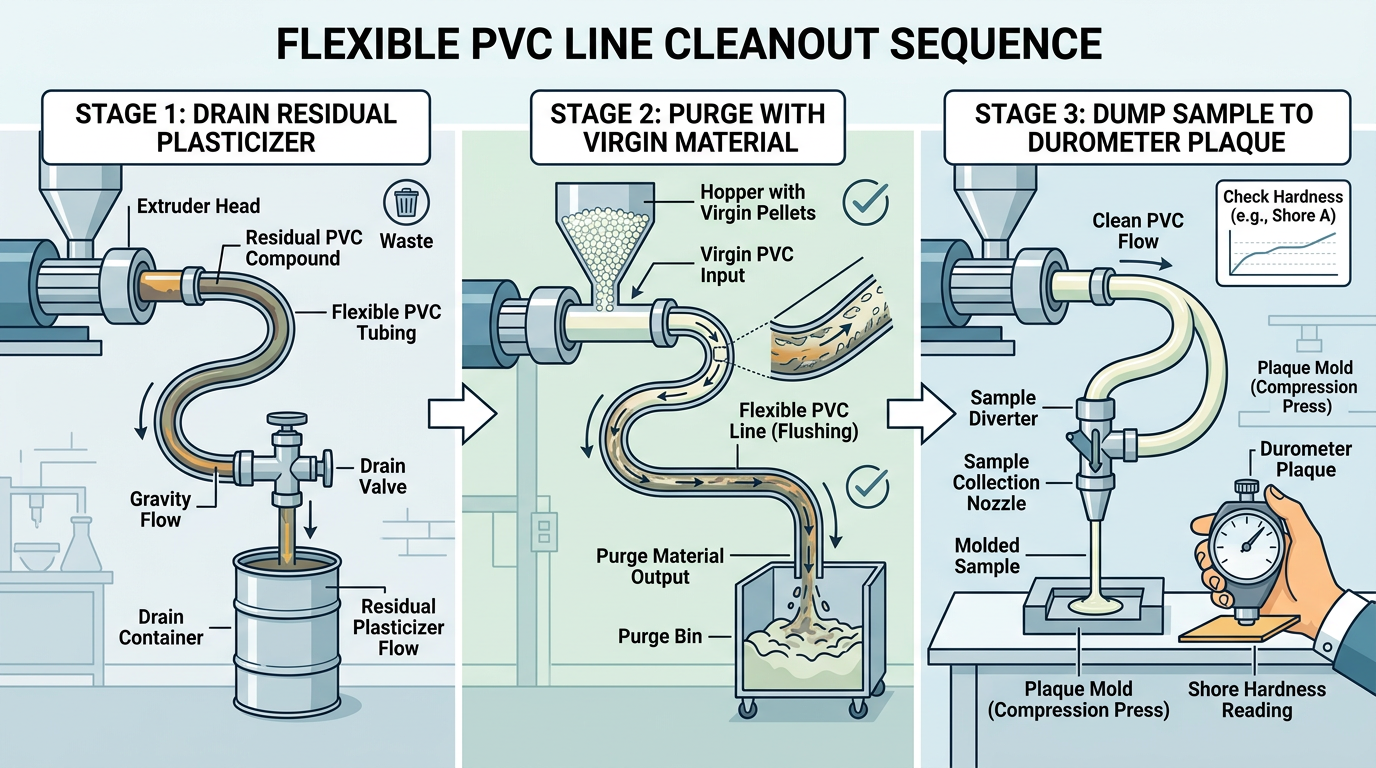

Production line cleanout sequence diagram for switch from DOP to DOTP

Switch the Formulation, Not the Mixer Setpoint

Two changes go on the formulation card now — a phr bump and a temperature ceiling. DOTP’s slower fusion is not a mixer-setpoint problem; treating it that way is the most common mistake at this stage.

Apply the phr ×1.03-1.05 Multiplier

The processing window for this formulation is a 3-5% phr bump and a small lubricant tweak — not a hotter mixer. Use phr_DOTP = phr_DOP × 1.03 to 1.05. Default to 1.05 for most flexible compounds; tighten to 1.03 for high-flexibility applications where over-plasticization causes Shore A drift downward.

At a 30 phr DOP / Shore A 70 baseline, that puts you at 31.5 phr DOTP for the same target hardness. The math is not pure mass — DOP and DOTP have nearly identical molecular weights — it compensates for DOTP’s lower polarity and reduced compatibility with PVC’s polar regions.

Hold the Mixer at the High End, Not Above It

On the processing side, hold the mixer setpoint at the high end of your existing 150-180°C window, not above it. DOTP’s flash point at 190°C is 10°C above DOP’s, which gives the calender / extrusion zone more thermal headroom — but headroom is not an instruction to run hotter.

Both temperature and shear contribute fusion energy; pushing temperature too high while shear is unchanged degrades the polymer network despite hitting a higher fusion number. Allow mixer dump time 5-10% longer than your DOP cycle (a 4:30 DOP cycle becomes roughly 5:00 on DOTP) and let the cycle finish on time, not on a hotter setpoint.

phr adjustment diagram for switch from DOP to DOTP plasticizer formulation

Run the Transition Batch After the Switch

The first DOTP batch is a transition batch, not a spec batch. Set three real-time checkpoints and three pass/fail numbers before you release first-spec product.

QC CheckpointPass/Fail ThresholdWhen to Read
Shore A drift vs target≤ 3 points24 h after molding plaque from dump sample
Fusion level (DCMT or acetone test)85-95%First extrudate / calender sheet
Plate-out on chrome rollNone visibleFirst 60 minutes of run

Shore A drift above 3 points means either the phr multiplier is wrong for this compound or residual DOP is still in the system — re-check the cleanout dump sample before adjusting phr again. Fusion below 85% means the line is not putting enough energy into gelation; the fix is mixer dwell time or calcium stearate, not setpoint. Above 95%, you risk degrading the polymer network and trapping voids in any vented profile.

Plate-out within the first hour is the residual-DOP signal — it should not appear at all on a clean transition batch. If the transition batch passes all three thresholds, run a second confirmation batch at full production volume before releasing first-spec product. Hold the first-spec batch for a 24-hour Shore A re-check; plasticizer-related hardness drift can surface a day later, not at minute thirty.

Calender chrome roll inspection during DOP to DOTP transition batch

Next Steps After a Successful Production-Line Switch

Write the cleanout SOP to a Shore A ±2-point dump-sample threshold, not a visual one — that single acceptance criterion prevents most transition-batch plate-out. Match the incoming COA to the lot you qualified your formulation against, hold the mixer at the high end of your existing temperature window rather than pushing it higher, and measure Shore A drift, fusion level, and plate-out as the three pass/fail signals on the transition batch before releasing first spec.

The judgment most engineers get wrong is reaching for the setpoint when fusion looks short; on a terephthalate line, almost every fix lives in dwell time, lubricant balance, or residual cleanout — not in heat. Once your line is stable, the next decision is application-specific phr targeting (flexible tubing, wire insulation, or sheet) where the 1.05 multiplier becomes a 1.03-1.05 range tuned per Shore A target.
